Marshall Municipal Utilities internet crew burying fiber optic cable in rural Saline County

USDA Broadband Grant Status

MMU has received two grants from the USDA in 2019 and 2020 to try to help offset the cost of expanding Broadband to rural areas of Saline County.

Below are maps of the areas we have been approved to work in and our progress in completing them.

Updated 12/19/24

Coleman Plumbing is working on Lemon Trail and Hwy UU. The new contractor, Kramer, is finishing up around Napton area and then working south of Malta Bend. MMU crews are continuing to blow fiber and splice as weather allows.

Bid Documents 2025

2019 Grant Progress

Grant 1 Map

Backbone construction is complete for Grant 1. Come in and sign up anytime.

All Areascompletestop by to sign up

2020 Grant Progress

Grant 2 Map

2022 Contracts

2023 Contracts

NOTE: The maps in the table below show planned areas in Grant 2. However, the contracts for conduit do not necessarily match the entire area for any given year. For example, the Kittyhawk map shows the entire Kittyhawk to Quarry area, but only the blue lines on the map are planned for 2023. The completion percentages in the table only reflect the part of the areas that are planned this year. There may be some additional conduit installed by MMU personnel which could increase what gets done this year. Bold lines on maps are the areas of construction.

Contract 2201 (South)Conduit Complete

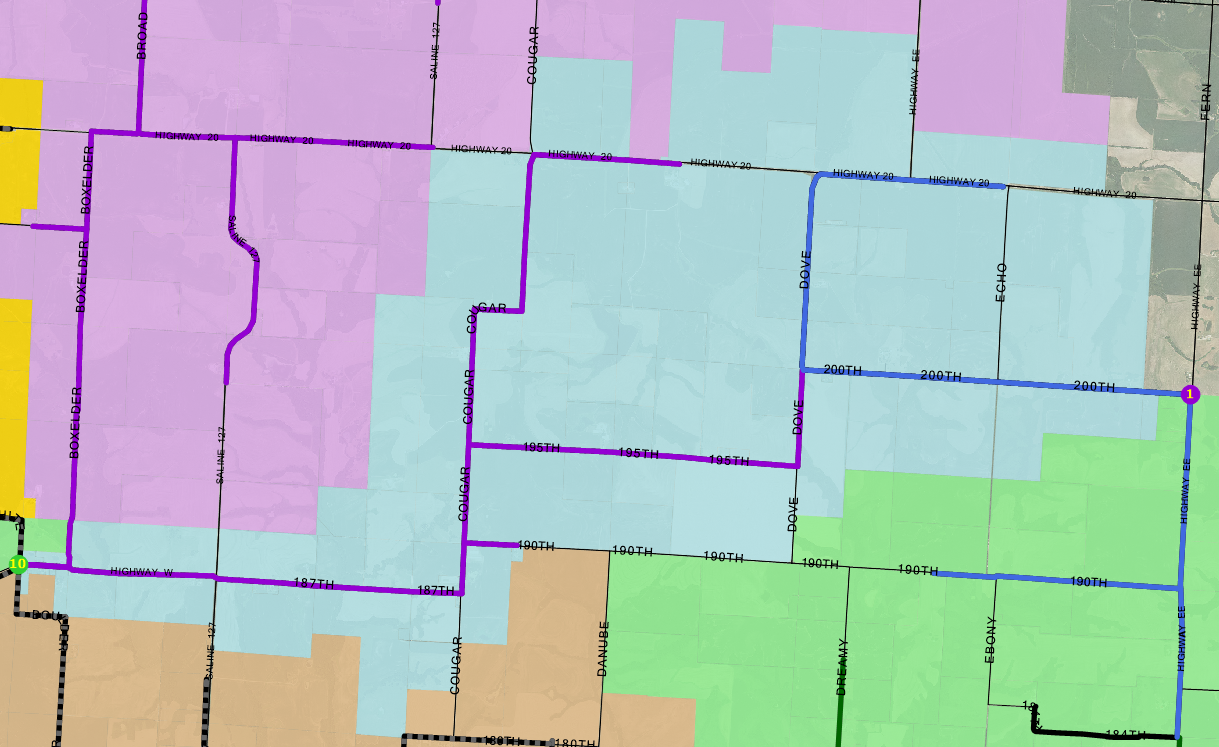

 Kittyhawk2023 portion completeMap
 165th Rd2023 portion completeMap
 Mt OliveCompleteMap
 YY Southconduit complete fiber 99%
complete
splicing 99%
complete
Map
 185th2023 portion completeMap
 EE South2023 portion completeMap
 200th2023 portion completeMap
Contract 2202 (West)Conduit complete

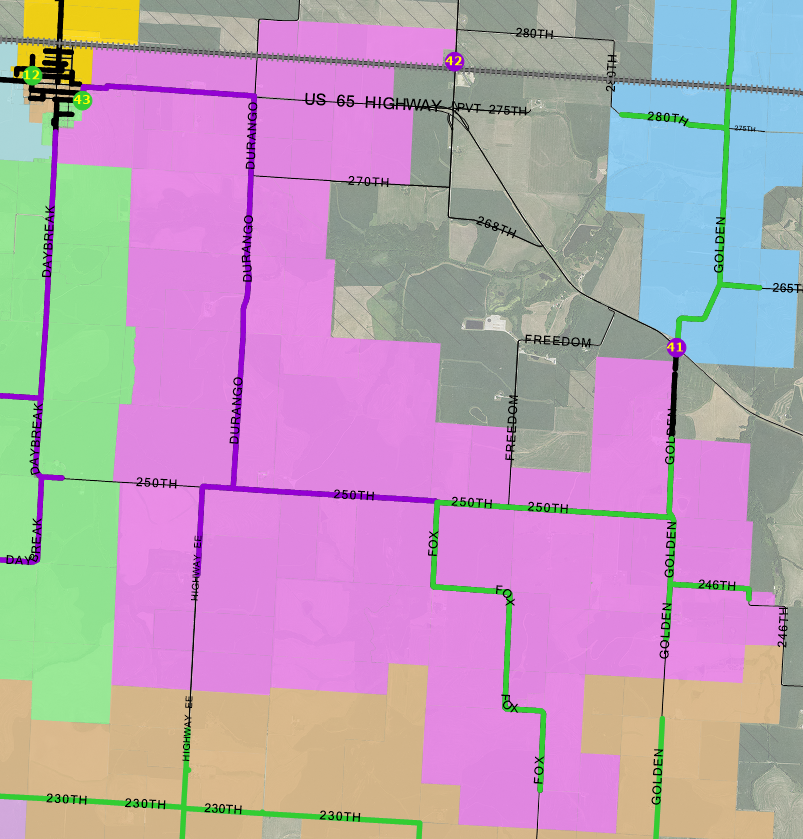

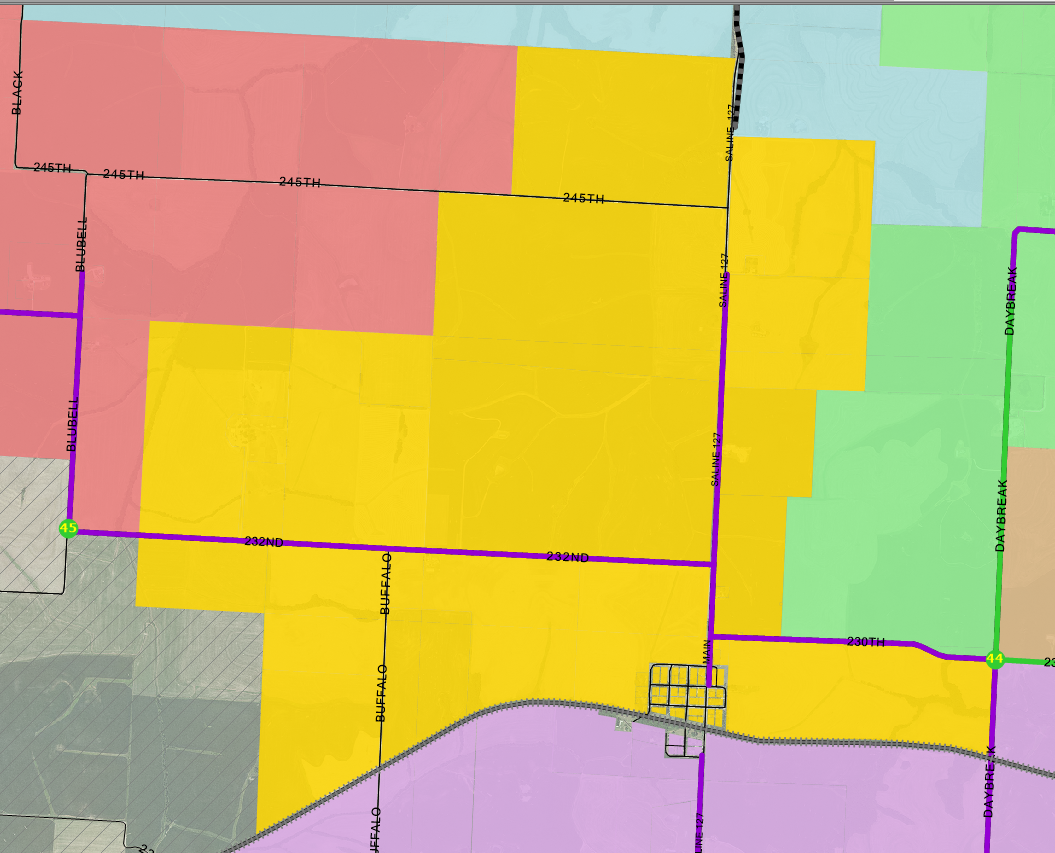

 Daybreak2023 portion completeMap
 230thCompleteMap
 250th2023 portion completeMap
 Golden Northconduit completefiber 95%
complete
splicing 95%
complete
Map
Contract 2203 (North)Conduit 99% complete
 WildcatCompleteMap
 KiteComplete Map
 41 NorthComplete Map
 KlondikeComplete  Map

 325th2023 portion complete  Map
Contract 2301 (East)Conduit completeMap
 Hwy 240contracted
conduit complete
fiber 90%
complete
splicing 95%
complete
Map
 230th Rdconduit completefiber 75%
complete
splicing 60%
complete
Map
Contract 2302 (Southwest)
Contract 2303 (West)Conduit 10% complete
Contract 2304 (Southeast)Map
 Water Tower/Smith Chapelconduit 99% completeMap
 Kittyhawk/Smith Chapelconduit 99% completeMap
 Magnolia/Nocturneconduit 99% completeMap
 Stuckeys/Smith Chapel2024 portion completeMap
 Smith Chapel/Nelson Westconduit 99% completeMap
 Nocturne/Nelson2024 portion completefiber completesplicing 90%
complete
Map
 Nocturne/Hwy TT2024 portion completefiber completesplicing 90%
complete
Map
Contract 2401 (South)
Kittyhawk/Smith Chapel2024 portion completefiber 20%
complete
Map
Kittyhawk/Quarryconduit 30% completeMap
QuarryMap
Quarry/JunctionMap
Contract 2402 (Quarry)conduit complete
Remaining Round 2Bid documents are available. Due back in January 2025.
